REKADAYA ELEKTRIKA IMMEDIATELY COMPLETE THE CONSTRUCTION OF JAILOLO 150 KV SUBSTATION

REINSITE highlight news about one of the main substation (GI) projects being carried out by PT Rekadaya Elektrika (RE), namely the Jailolo 150 kV GI construction project. The project, which is located in West Halmahera, North Maluku Islands, was entrusted to RE by PT PLN (Persero) Maluku & Papua Main Development Unit, to support the reliability of the Maluku Island electricity system.

As of week 1 of August 2023, the progress of work in the field that has been achieved is 91.01%. Currently the project team is carrying out testing of Electrical-Mechanical (EM) equipment, and several civil works that are being completed include spreading gravel in the switchyard area, working on access roads and concrete panel fences, as a requirement to obtain a Recommendation Letter for Tensibility (RLB).

Various obstacles, both from a technical and non-technical perspective, are often faced by project teams in the field. However, with the spirit of AKHLAK, the project team is always ready to overcome it by continuing to establish good coordination and synergy with the team from UPP Ternate and UIP Maluku & Papua as owners.

Read More

CONSTRUCTION PROGRESS OF SUTT 150 KV TANJUNG REDEB – TALISAYAN

Kali ini kita akan membahas salah satu project Transmission Line (TL) yang sedang dikerjakan oleh PT Rekadaya Elektrika (RE). Project yang dipercayakan oleh PT PLN (Persero) UIP Kalimantan Bagian Timur ini terbentang sepanjang 72 KMR dengan total tower sebanyak  195 titik tower yang menghubungkan Gardu Induk (GI) Tanjung Redeb dan Talisayan. Pembangunan SUTT 150 kV Tanjung Redeb – Talisayan ini bertujuan untuk menopang keamanan dan kehandalan sistem kelistrikan pulau Kalimantan melalui interkoneksi antar sistem kelistrikan Kalimantan utara dan Kalimantan timur.

Adapun yang menjadi scope pekerjaan Rekadaya Elektrika dalam project ini meliputi pembangunan pondasi, pengaman material tower,

pengadaan material konduktor, pekerjaan erection tower, penarikan kabel dan comissioning.

  • SUTT 150 kV GI Tanjung Redeb – GI Talisayan Section 2

Progres pekerjaan per week 3 Juli 2023:  17,99%

Panjang Jalur Transmisi: 35,96 KMR (70,54 KMS)

Jumlah Titik Tower: 96 Tower (T.100 – T.196). Saat ini 68 titik lahan telah bebas dan telah dibangun sebanyak 56 pondasi tower dengan target selesai seluruhnya di bulan September 2023.

Pekerjaan ongoing: pembangunan pondasi, pengecoran pad dan chimney. Sedangkan pekerjaan erection tower direncanakan akan dimulai pada

TW 3 2023.

  • SUTT 150 kV GI Tanjung Redeb – GI Talisayan Section 3

Progres pekerjaan per week 3 Juli 2023:  16,13%

Panjang Jalur Transmisi: 36,04 KMR (72,08 KMS)

Jumlah Titik Tower: 99 Tower (T.196 – T.294). Saat ini 75 titik lahan telah bebas dan telah dibangun sebanyak 60 pondasi tower.

Pekerjaan ongoing: pendampingan pembebasan lahan, pembangunan pondasi, pengecoran pad dan chimney. Sedangkan pekerjaan erection tower direncanakan akan dimulai pada TW 3 2023.

Read More

ENERGIZED Extention 2 Line Bay GI 150 kV Pagelaran

Proud news has come again from colleagues from the PT Rekadaya Elektrika (RE) site project team, because on Saturday, July 15 2023, the RE team in the field has successfully carried out the energized project Extention 2 Line Bay Substation 150 kV Pagelaran located in Pringsewu, Lampung.

The project, which was entrusted by PT PLN (Persero) for the Southern Sumatra Main Generation Unit (PLN UIP SBS), has succeeded in energizing it. After previously obtaining a Voltage Worthy Recommendation Letter on Thursday 13 July 2023. Next, the project team together with PUSERTIF will carry out a 24-hour loading test.

Appreciation was conveyed by Mr. Wahidin as GM UIP SBS, Mr. Ndaru Seto as SRM OPKON UIP SBS, and Mr. Haryo Wisnuaji as UPP SUMSEL 3 Manager who were present in person to witness the energized process. Mr. Haryo Wisnuaji as MUPP SUMSEL 3 expressed his gratitude for the hard work given by the Electrical Engineering Team so that this project was successfully carried out.

Mr. Indrayoga Suharto as Business Director I Rekadaya Elektrika, who is also the direct supervisor of this project, expressed his gratitude for the well-developed collaboration between PLN UIP SBS, UPP SUMSEL 3 and RE, so that this project could be completed. We hope that the success of this project will benefit PLN UIP SBS as the owner and the wider community.

Read More

REKADAYA ELEKTRIKA REVITALIZES MAIN STRUCTURE CONVEYOR PLTU TANJUNG JATI

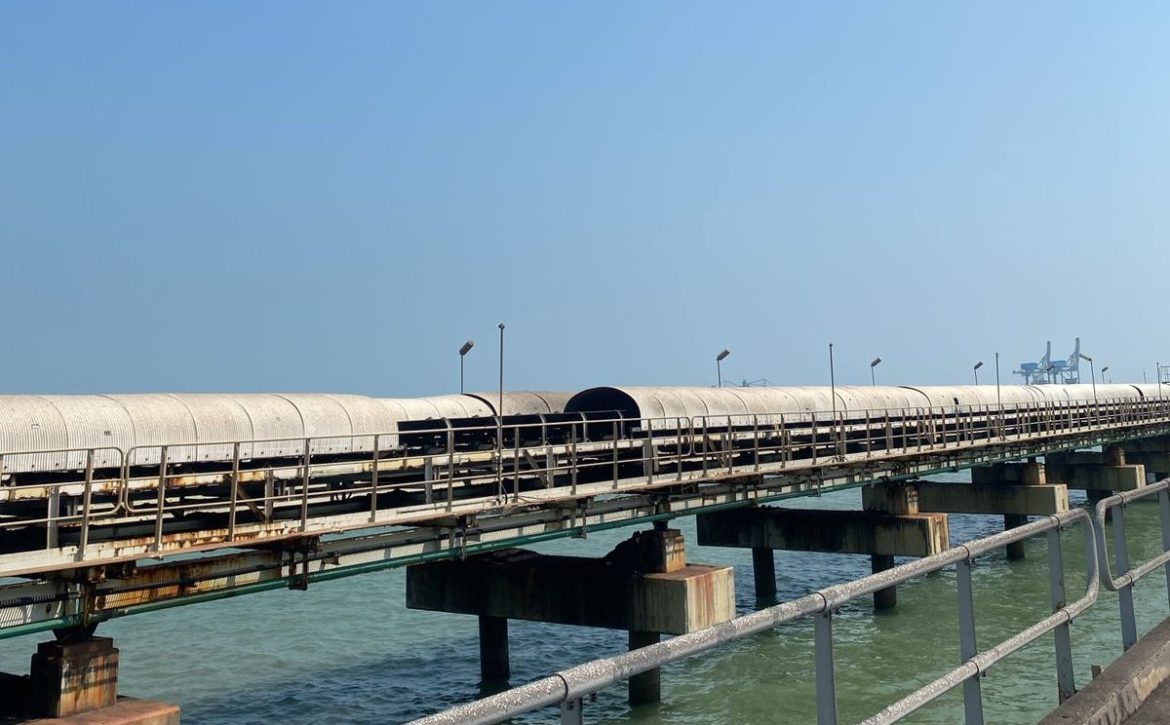

In order to support electricity in Central Java Province, PT Rekadaya Elektrika (RE) is working on the Revitalization Steel Structure Conveyor project on the Jetty at PLTU Tanjung Jati. As the main contractor of the project is PT Komipo Pembangkitan Jawa Bali (KPJB) Tanjung Jati.

The scope of work that is the responsibility of Rekadaya Elektrika is preparatory work, procurement of steel structure (conveyor) materials and repair / revitalization of steel structure. Until mid-2023, the progress of the revitalization work of the main structure of the conveyor PLTU Tanjung Jati B, overall progress has reached 8,770%.

Obstacles from the technical and non-technical side (nature) are of course often experienced by the project team in the field, however the project team remains enthusiastic to play an active role in making a real contribution to providing light and increasing the reliability of the Central Java province’s electricity system through the Tanjung Jati PLTU.

Read More

Boiler Retubing Work Unit 3 of PLTU Indramayu

Rekadaya Elektrika (RE) successfully completed the Unit 3 Boiler Retubing Procurement Project owned by PT PJB UBJOM PLTU Indramayu which has been functioning and operating properly.

The Boiler Retubing Procurement Project is led directly by Mr. Mach Novviali as Project Manager. The project consists of 2 stages of work, namely:

  • ·       Boiler tube fabrication stage which was completed on March 21, 2022.
  • ·       Installation stage of the boiler tube which was completed on February 09, 2023.

The Rekadaya Elektrika project team successfully completed the installation work within 3 months, and currently the unit 3 boiler retubing project is entering a 24-month maintenance period.

Read More

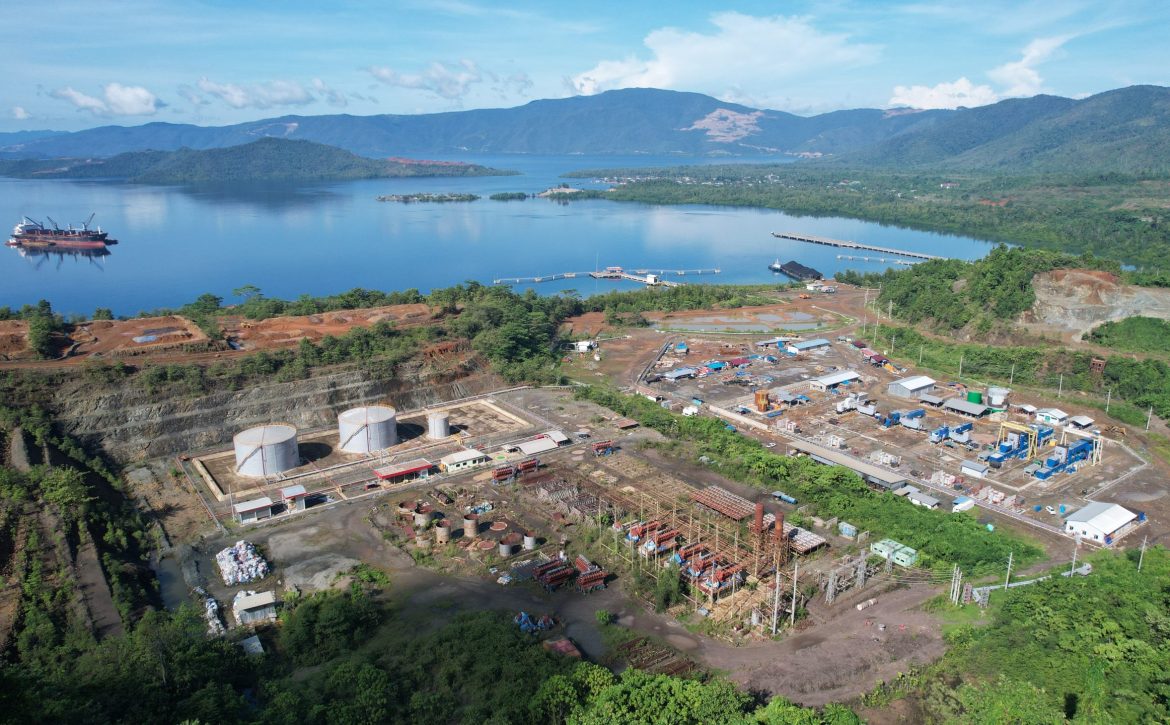

REKADAYA ELEKTRIKA SUCCEEDS CARRY OUT BACKFEEDING SOFIFI PLTU 2X3 MW

RE-Insite again delivered encouraging news regarding the progress of the construction of one of the Steam Power Plant (PLTU) projects undertaken by PT Rekadaya Elektrika (RE) which is located in the Maluku islands, precisely in the North Halmahera region.

As of the 4th week of July 2023, work in the field has reached a progress of 35.305%.  Currently the project team in the field is working to complete the installation of pipes and power cables, as well as the testing & commissioning stages of Low Voltage (LV) & Medium Voltage (MV) Switchgear and testing & commissioning for transformers. And on Saturday July 8, 2023, the RE project team has successfully carried out backfeeding.

What is backfeeding? Backfeeding is a stage of the power plant development process that utilizes a temporary connection of electrical energy from PLN’s 20 kV system, which is used for testing the readiness of equipment in the generating system.

PT PLN (Persero) UIP Maluku Papua as the owner also expressed appreciation and gratitude for the hard work given by the RE project team for successfully carrying out one of the milestones, namely Backfeeding in accordance with the initial target. While advising that the RE project team remains focused on completing the next stage of work.

By upholding the value of Amanah, RE is committed to completing the construction process of the Sofifi 2×3 MW PLTU project to bring light across the country.

Read More

Progress Project of Transmission Line 70 kV Substation Namrole – Substation Namlea

This time we visit one of the transmission line project locations that is being worked on by PT Rekadaya Elektrika (RE). It is the 70 kV Namrole – Namlea Transmission Line project which will connect two substations (GIs) namely Namrole GI and Namlea GI, which crosses 7 villages with a total distance of 90.3 kilometers.

In the middle of 2023, the overall work progress has reached 89.54%. Currently the total land that has been acquired has reached 93.16%, with a total of 229 foundations that have been completed from the target of 235 tower foundations (94.01%). While the total towers that have been successfully established are 222 towers from the target of 235 towers (76.35%).

Rekadaya Elektrika continues to strive to achieve progress in the construction of this transmission line, so that it can immediately meet the electricity needs of the people in Maluku, especially South Buru Island.

Read More

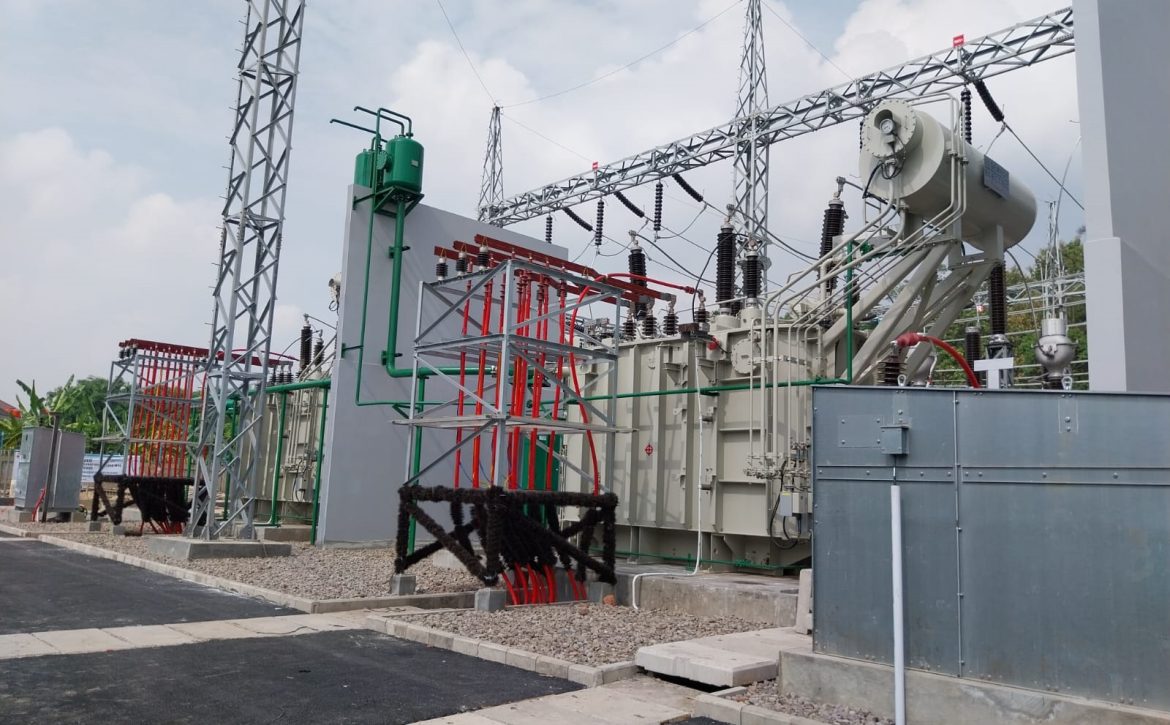

Energized Substation 150 kV PENDO

The PT Rekadaya Elektrika (RE) Project Team again delivered encouraging news while showing an attitude of trust through the implementation of energized one of the substation projects, namely the Construction of Extension 2 Transformer Bay GI 150 kV PENDO on Saturday, May 27, 2023.

The work, which was led by Pongging as Project Manager, successfully carried out the provision of voltage after obtaining a Letter of Recommendation on May 26, 2023. Representing the Project team, he expressed his gratitude for all the support provided by the head office management team so that the 150kV PENDO GI project could be energized.

PT PLN (Persero) UIP JBB as the owner also expressed his appreciation and gratitude to RE for successfully completing the construction of the 2 transformer bay extension of GI 150 kV Pendo, although it is still not 100% perfect.
